Factor in project constraints
Deadline certainty and fixed scope are different commitments, and conflating them is how iterative delivery gets blamed for problems it never caused. A regulatory deadline and a contracted go-live: those are fixed dates. What ships on that date is a separate question, and every model handles it differently.
Scrum absorbs change by moving it to the next sprint boundary, which protects focus but means urgent requests wait. Kanban absorbs change by reordering the queue, which serves volatile demand but weakens medium-term forecasting. If your contract is firm fixed price, the model has to be paired with a change mechanism, which is why arrangements like Jeff Sutherland's "Money for Nothing, Change for Free" require an item of comparable effort to leave the backlog whenever a new one enters.
Supplier structure matters as much as the contract. A team split across your staff and an external partner needs one backlog and one owner. Where you're using extended or managed teams, the practical difference for Agile vs Scrum is who provides the product owner, and that single answer changes which model is viable.
Govern iterative delivery
Governance that tracks tasks will slow an iterative team without telling you anything useful. The UK Government Digital Service sets out six governance principles for Agile delivery that begin with "do not slow down delivery" and end with "trust and verify". The point of those principles is that oversight should focus on outcomes and decision rights rather than on inspecting work in flight.
Build your governance around a short evidence set rather than a status pack. Progress towards the business outcome and the working product delivered so far. Sprint reviews and flow metrics both produce that evidence naturally, which is why the reporting burden falls when governance is designed around the model instead of bolted onto it.
Regulated delivery doesn't change the answer. AAMI's TIR45, recognised by the FDA in its 2023 revision, exists precisely because manufacturers and regulators needed a documented answer to whether Agile software development suits medical device software. Regulations require defined activities and evidence. They don't prescribe a development sequence. Your audit trail comes from the definition of done and the traceability of backlog items.

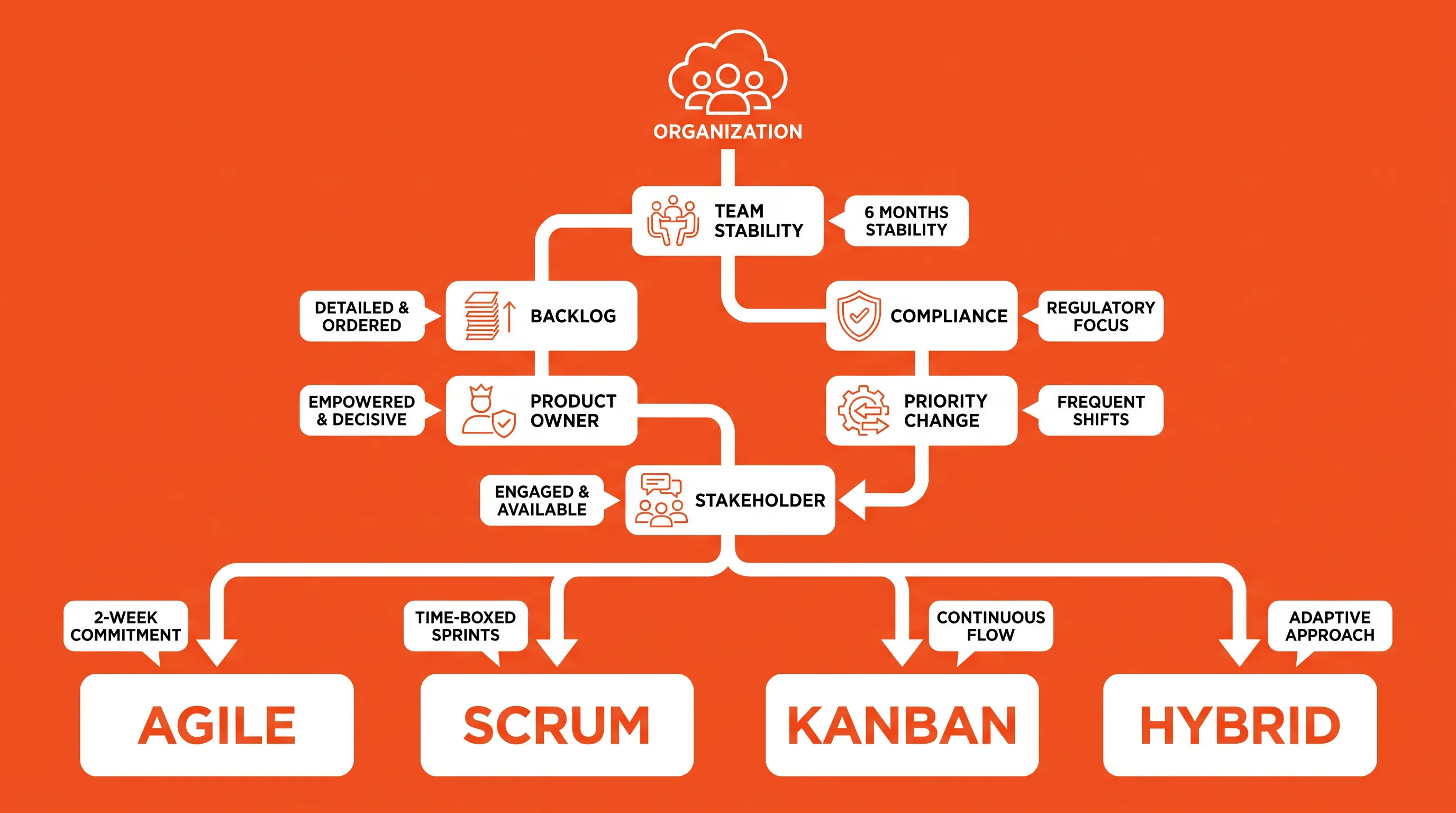

Agile vs Scrum decision tree

Run this in order and stop at the first branch that describes you honestly. The Agile vs Scrum choice resolves faster when you answer about the organisation you have rather than the one in the transformation plan.
-
Is demand predictable enough that a two-week commitment survives most weeks? If no, start with Kanban and revisit in a quarter.
-
Do you have a named, empowered product owner and two sprints of ready backlog? If no, Scrum's overhead buys you nothing yet.
-
Is the team stable and cross-functional for the next six months? If no, flow-based delivery will give you more reliable forecasts.
-
Are stakeholders available fortnightly with decision authority? If no, Scrum's review loop breaks and Kanban's service level expectations serve you better.
-
Do compliance or multi-supplier dependencies force separate tracks? If yes, design a deliberate hybrid with written rules for each track.
-
Does the priority order change more than once a fortnight? If yes, Kanban. If it's stable across a sprint, the Scrum framework fits.
Answer yes down the list, and Scrum is the right call. A single no on decision authority or team stability points to Kanban. Two or more no answers alongside a fixed contractual date point to a hybrid you design deliberately.
Agree during discovery
Settle the Agile vs Scrum model before delivery starts. A discovery workshop is where that happens, and the attendee list is the part organisations get wrong. The business sponsor and product decision-maker, along with the technical lead and the supplier's delivery lead. Missing any of those means the rules you agree won't survive contact with the people who weren't there.
Independent discovery works because the people running it have no stake in the answer being "build it now". Product discovery tests assumptions in Agile software development before budget commits. The delivery model conversation belongs in the same session, because your answers about ownership and cadence are the inputs to it.
Leave the workshop with these agreed and written down:
-
Named owners for priority, technical decisions and sign-off
-
Cadence, backlog readiness standard and definition of done
-
Governance forum, evidence set and the metrics you'll report
-
Change rules and the first three review dates in diaries
Everything in that list is a business decision. Which is why it can't be delegated to the development team and discovered later.
Where this leaves you
The right delivery model for Agile vs Scrum is the one your organisation can actually staff and govern. Get that judgement right and iterative delivery gives you working software to inspect every fortnight. Get it wrong, and you buy the ceremonies without the control.
